Better than estimates
Estimates are ubiquitous in software development. People routinely use them for planning, prioritization, and managing expectations. All these activities are crucial for project management, but are estimates really the best tool for the job? Surprisingly, often, the answer would be "no." In this post, we'll explore how estimates slow us down and what alternative tools we could use instead:
- Due dates, a.k.a. Deadlines if we need to fit into a certain timeline and/or budget;
- T-shirt sizing for tasks prioritization;
- Regular check-ins to identify stuck progress, minimize waste, and manage expectations better;
- Postponed estimates when you just need a classic estimate.
Estimates slow us down
One of the most unpleasant effects of relying too much on estimates is that they slow the team down. Here's how it happens.
1. Initial estimates are very uncertain

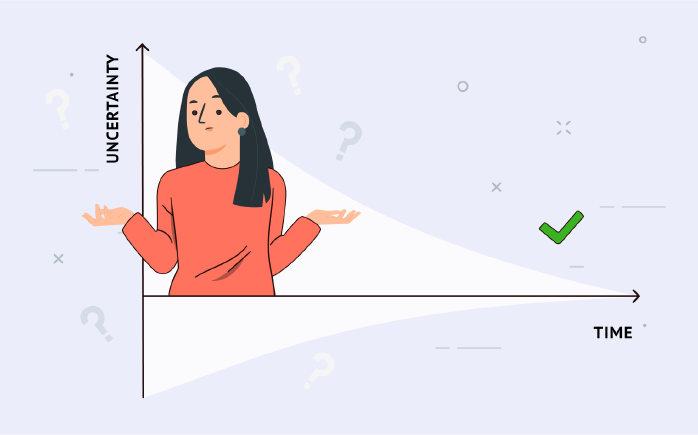

Managers are most interested in estimates before starting work on a task or a project, which is quite understandable. Unfortunately, this is also the time when estimates are the most unreliable. This effect is known as the Cone of uncertainty - the more we work on the project, the better we understand how long it might take:
There were studies on how big that initial estimation error might be. It turns out that in software projects, it can be up to 4x off in either direction. For example, when people say "a couple of weeks," it could be anywhere between 2-3 days and a couple of months! Such a huge range may sound surprising to some, but ask any seasoned developer, and they will recall numerous cases from their practice when a "quick one-day task" ends up taking many weeks.
2. Developers quickly learn to overestimate
Of course, no one wants to deal with estimates that range from a few days to a few months. Managers are asking for estimates because they need something to rely on, and such a wide range isn't helpful in this regard. They expect estimates to be more precise and perceive them as some kind of promise. If a developer is lucky enough to finish the task faster than expected, this is great, and no one would complain. But if the work is delayed, people may become frustrated. So there's a natural incentive for developers to overestimate—it's just safer for them.
At first, developers tend to be optimistic about timelines, but they quickly learn that their estimates often fail, which could be an unpleasant experience. They realize that it makes sense to add a safety margin, and estimates go up.
3. Work expands so as to fill the time available for its completion
If developers overestimate, they must complete most of their work earlier than expected, right? Nope! This is where Parkinson's Law comes into play:
Work expands so as to fill the time available for its completion.
So this is how estimates slow us down - developers overestimate, and then that pessimistic estimate becomes the earliest date when the work could be finished. Unfortunately, there's no easy workaround for it. Pressuring developers to give lower estimates demotivates the team (why are you asking us if you already know how long it must take?) and will backfire because there are reasons why they overestimate.
Bonus: additional slowdown due to introduced misconceptions
Estimates also introduce dangerous misconceptions that further slow down a process that heavily relies on estimates. As Frederik Brooks famously noted in The Mythical Man-Month book,
Men and months aren't interchangeable
If one developer can complete a project within a month, it doesn't mean another developer can do the same. Maybe they can or maybe not; it depends on their skill, experience, productivity, and how well they know this project area. However, this important aspect is often neglected. For example, in SCRUM, people plan their work relying on universal task estimates and "team capacity," while in reality, performance may vary significantly depending on who is assigned to which task.
It contributes to the list of reasons why people reserve extra time in project plans to handle various "unexpected situations." But for whom this situation is "unexpected"? Most managers would agree that generally speaking, men and months aren't interchangeable. However, it's really hard to account for that in frameworks like SCRUM, so people consciously choose to ignore it and just add some extra time to hide planning inefficiencies.
Predictability comes at a cost
It is understandable that people want their software development process to be predictable. Many organizations go to great lengths to achieve this, for example, by estimating all of their work, calculating team "velocity," introducing burndown charts, and encouraging developers to give "more accurate" estimates. The truth is, it has its price, and the price is slowness.
Software development has some unpredictability by nature because it's not a fully repeatable process. Of course, there are some routine tasks, but developers don't spend too much time on them due to code reuse and automation. Most of their time is spent on something new. It could be working with a new library or an API that they didn't use before or debugging a tricky bug. Developers simply don't know how long it might take, so their only way to achieve predictability is to overestimate.
For some companies, sacrificing speed is a reasonable tradeoff for predictability. However, if you are interested in moving faster, it makes a lot of sense to accept that software development can't be fully predictable. We'd better allow some degree of variation and uncertainty. That doesn't mean that the project would become chaotic and unmanageable, though. In the chapters below, we'll explore techniques for managing projects without relying on estimates too much. We aren't going to throw away estimates completely. It can be a useful tool, but it should not be the only tool in the manager's toolbox.
Meet deadlines
Let's talk about situations when we need to fit into a certain budget and/or timeline. For example, we've got a small "idea-stage" investment for our startup, and we have a few months to demonstrate its potential to get more funding. Another example - we're running an e-commerce store and would like to upgrade our discount and bonus program before Black Friday. These are examples of natural deadlines, when we need to get something out of the door before the deadline, or the world will move on without us. In such situations, we'd better operate in the "deadline mode" rather than "estimate mode."
Deadlines aren't bad
Deadlines may sound scary. They're often associated with stress, burnout, cutting corners, or poor planning overall. Even the word itself sounds bad—we certainly don't want anyone to die! Such a bad reputation pushes people away from deadlines towards "safer" estimates, which I think is very unfortunate.
Of course, there are many ways to abuse deadlines, like setting arbitrary deadlines or asking for estimates and then treating them as deadlines. However, as shown above, there are plenty of ways to abuse estimates, too. Estimates aren't "safer". Neither deadlines nor estimates are a bad concept. They are just tools, and how we use these tools makes all the difference.
Estimates vs. deadlines

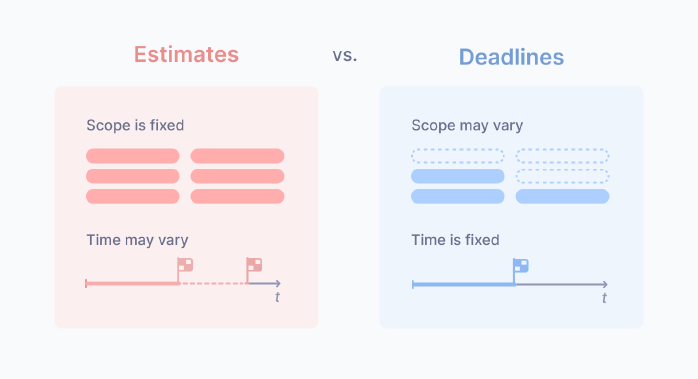

On the surface, estimates and deadlines may look like close concepts. They both are about the project completion time, but they work very differently. When we ask for an estimate, we assume that the project scope is more or less fixed and the completion time is flexible. When we set a deadline, the time is fixed, but we must accept that the scope may vary:
It might be tempting to fix both scope and time, but experienced managers know this is a bad idea. Either we won't be able to complete everything, or there will be problems with quality, or the timeline must be so relaxed that the project won't look viable from the business perspective. So, when setting a deadline, allow flexibility in the scope.
Deadlines facilitate prioritization
When we might not have enough time to complete everything, we naturally ask, "Okay, what's the most important?" Great question! There are usually many ways of achieving the same goal when building software, and not all features and requirements are equally valuable. Time constraints force us to set priorities, and clearly defined priorities significantly reduce the project risks.
Meeting deadlines reliably
The approach that we use at ivelum when we need to meet a deadline is a combination of the Fix Time and Budget, Flex Scope technique, and Continuous Delivery:
- Write down all known requirements as separate features, which we could ship independently;
- Prioritize the features from the most important to the least important;
- Establish conditions for Continuous Delivery - ensure that the production environment and CI pipelines are ready;
- Ship the updates frequently, starting with the most important features, and keep the system fully functional at all times.
Continuous Delivery helps further de-risk the project by ensuring that the MVP lands in production as early as possible. After that, we continue adding features to it, trying to build as much as possible before the deadline and continuously testing the new system as a whole.
When deadlines work best
Deadlines work best when there's a natural deadline that we can easily explain to the team, and explaining it is important. First, we need to get a commitment from the team, and people are reluctant to commit to arbitrary deadlines (which is quite understandable). Second, it guides our prioritization. Knowing why the deadline is set helps us understand what would be critical to ship by that date.
However, deadlines shouldn't be ubiquitous, even with the best explanations and reasoning. Definitely don't put a deadline on every task 🙂
T-shirt sizing
Another common reason why people ask for estimates is prioritization. The common logic is this - if it's a quick task, let's do it now, or if it takes significant time - maybe postpone. While the initial implementation time shouldn't be the only criteria taken into consideration, having this information could be helpful, especially for non-technical managers.
T-shirt sizing provides a very rough estimate of how large the task could be - S (small), M (medium), or L (large). It allows managers to compare tasks to each other and helps make decisions on their priorities.
If the task looks large, try to explain why it looks large. Can it be simplified so that we can achieve the same goal with less effort? Quite often, this is possible.
Please note that it's very important to avoid linking these sizes to the estimated completion time. As soon as people start to associate these sizes with concrete date ranges, we are back to classic estimates with all their shortcomings.
Story points in SCRUM tried to mix the same idea with better predictability and utterly failed. Everyone quickly learned to convert these magic numbers to days, which is unsurprising, as they're used for planning on fixed periods (sprints). Even the story point's inventor regretted inventing them. Don't repeat this mistake; don't tie t-shirt sizes to date ranges.
Regular check-ins
Sometimes, managers treat an estimate as a checkpoint when to communicate with the developer next time:
- Hey, how long it might take?
- Maybe a couple of weeks?
- Okay, I'll check back in a couple of weeks.
It may sound reasonable at first—we don't want to distract developers while they're working, so why not check back when they're supposed to finish? The problem is that it could be too late. There are many unknowns that developers unpack one by one as they progress through the task.
Frequent discussions of progress help identify bottlenecks and allow us to adjust requirements on the fly if it turns out that the original task is more complicated than we initially thought. The optimal check-in schedule may vary from one team to another. Some use daily standups, while others prefer weekly or another schedule. Standups are usually associated with SCRUM, but you don't have to go full-SCRUM to do standups—just do standups! When done right, they minimize waste of time and keep the manager well-informed about the real situation on the project.
What if we actually need an estimate?

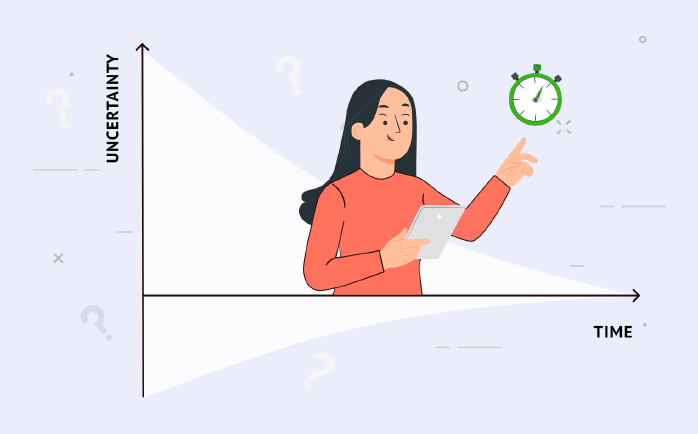

Even if we effectively use all of the tools above, there could be situations where we still need to get a classic estimate to communicate it to clients or stakeholders. In such cases, ask for it later, if possible.
Remember about the Cone of uncertainty - the more we work on the project, the better we understand when it can be completed. When developers haven't started yet, they may have no idea. However, as they make progress, it should become more evident what it'll take to complete the project, and we'll likely get a more reliable estimate that would be safer to communicate to someone else (with a safety margin on top of it, of course 🙂)
Summary
Estimates are overused in software engineering, which often leads to poor planning and underwhelming team efficiency. While estimates have their place, they shouldn't be the only tool in the manager's toolbox. There are other tools that work better in many situations:
- If you have a timeline to meet - use deadlines! Being flexible with scope, rigorous prioritization, and continuous delivery is a recipe for success;
- If you need to decide what to work on next - consider T-shirt sizing estimates and if the task looks large, try to figure out why;
- There's no need to ask for an estimate to decide when to check the task progress next time - just check it regularly, no matter what, and the progress will be more reliable;
- Finally, if you just need a classic estimate measured in days - see if you can give developers a few days to work on the task before asking for an estimate. It significantly improves the chances of getting a more accurate figure.
